|
ID-164-WCooperative Extension Service
|
Because many of the soils in Indiana are not well
suited for disposal of residential wastewater,
innovative septic system designs often are required
for satisfactory performance. A pressure distribution
system is one such design. Pressure DistributionNonconventional types of septic systems require
more care than conventional ones in site selection,
design, and construction. This is due not only
because the contractor is apt to be less experienced
with pressure distribution installation but, also
because soil and site conditions may be difficult. A. Site Selection and LayoutStep 1: The selected site must be one that
sheds water. The long axis of the soil disposal area
must be oriented parallel to the contour of the slope
(i.e., lines of equal elevation). Try to avoid areas
where the long axis would run up or down the slope or

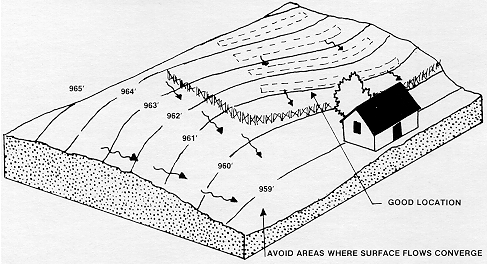

where wastewater movement will converge (Figure 1).
Because a pump generally is used to pressurize the
system, the soil disposal area can be located upslope
from the home. (Of course, this would not be an
option if a siphon is used to pressurize the system).
A contour or topographic map is rquired to determine
the best layout (Figure 1). Figure 1. Proper orientation of trenches on complex slopes.Step 2: Lay out and stake the
location of the feedline trench, septic tank, and pump

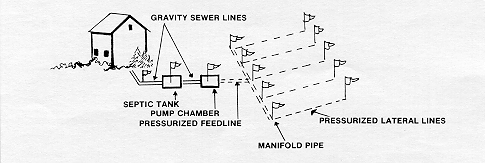

chamber (Figure 2). Their exact locations may be
dictated by minimum distance requirements from water
supplies, structures, property lines, and bodies of
water as outlined by Indiana State Board of Health
regulations. These setback distances are also part of
the FACTS program. Figure 2. The entire system, including the location of the septic tank and pump chamber, should be layed out and staked before construction.Step 3: Stake the center line of
all soil trenches. Trenches should be spaced a
minimum of 7.5 feet center-to-center, or as specified
by the computer program. The greater the slope or the
more impermeable the subsoil, the greater the spacing
needed to keep from overloading the soil of the lower
trenches since wastewater will tend to move more

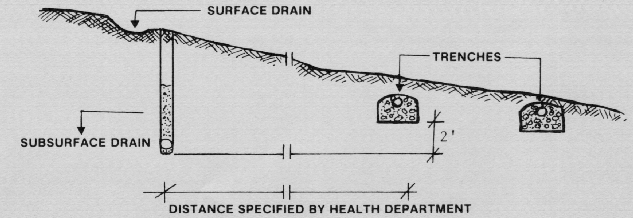

horizontally than vertically. Figure 3. Locations of subsurface and surface drains.B. Trench Excavation and PreparationStep 1: The trenches should only be
excavated when the soil is dry and friable. Smearing
and compaction due to construction in a wet soil
decrease the soil's ability to absorb wastewater. If
a sample of the soil at trench bottom depth forms a
ribbon (e.g., 1/8-inch diameter) when rolled between
the palms of the hands, the soil is too wet to
excavate. If the soil crumbles, excavation may

proceed (Figure 4). This preexcavation investigation
is essential to help ensure proper operation of the

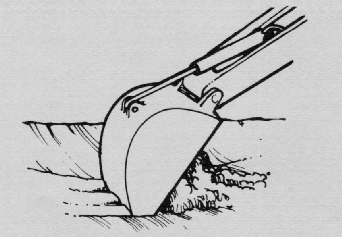

system. Figure 4. Construction must not take place if soil is too wet.Step 2: Trenches should be kept as
shallow as possible to take advantage of the more
permeable horizons near the soil surface. The FACTS
program will automatically do this by specifying the
trench bottom depth for the site. Figure 5. Keep backhoe bucket perpendicular to trench bottom to minimize compaction.Sides of lateral trenches should also be raked to a
depth of 1 inch to expose the natural soil structure
and to remove any smeared and compacted soil surfaces
caused by the excavating bucket. This can be
accomplished by attaching fabricated raker teeth to

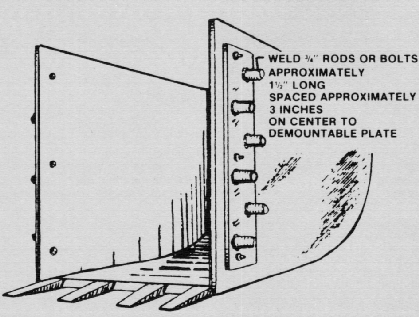

each side of the bucket (Figure 6). Foot traffic on
the excavated trench bottoms should be minimized to
prevent further compaction. If foot traffic is
necessary, use planks to spread out the workers'
weight. Figure 6. Fabricated raker teeth to reduce compaction and smearing of trench side walls.Step 3: Excavate a narrow trench for
the manifold pipe between the lateral trenches either
at one end or in the center of the soil disposal area,
depending on the lateral pipe layout recommended by
FACTS program. To prevent plugging or freezing,
the manifold must be placed so that it will drain

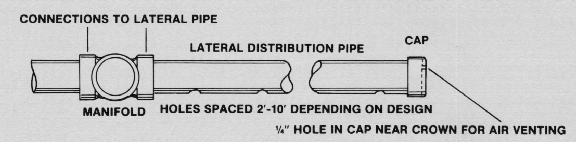

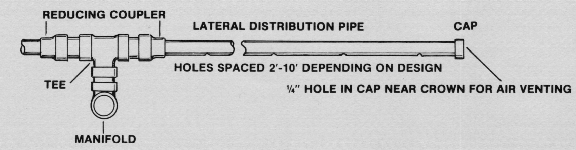

between doses. It should drain into the lateral
distribution pipes (Figure 7) or back to the pump
chamber if connected to the lateral distribution pipes
from below (Figure 8). Then excavate another trench
for the feedline, either from the center or from one
end of the manifold trench to the pump chamber, along
the path staked out in Step 2 of Part A. The feedline
should also be laid at a slope that permits drainage
between doses to the pump chamber. Otherwise, the
feedline must be placed below the frostline (about 40
inches in most of Indiana). Figure 7. Sanitary cross connection. Drill 1/4-inch hole on underside of manifold downslope end with feedline drainage to pump chamber.Figure 8. Tee-to-tee connection. Feedline and manifold must drain back to the pump chamber.Once the properly sized manifold and feedline are laid
to the desired grade and connected to the lateral
piping, place soil around the manifold pipe and
compact it well to prevent wastewater from seeping
along the manifold from one lateral trench to the
next. This is especially important on sloping sites
where successive lateral pipes and trench bottoms are

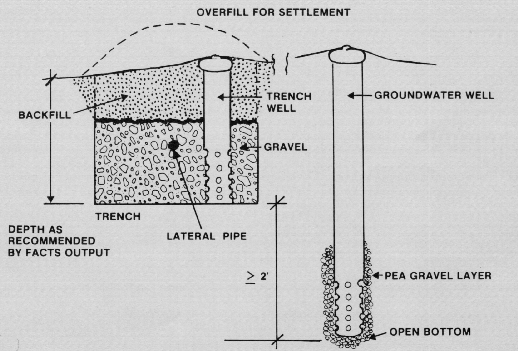

placed at lower elevations. Figure 9. Monitoring wells shown in completed trench and outside of absorption field.After completion of the system monitoring wells also
can be installed outside the absorption field to
evaluate seasonal groundwater levels which will affect
the system's performance. These wells should extend
to a depth of 40 inches or at least 2 feet below the
elevation of the nearest trench bottom, whichever is
greater. C. Pressure Distribution Network InstallationStep 1: Carefully place washed Indiana State
Highway Specification (Spec) #5 aggregate, or other
trench fill material which has been approved by the
County Sanitation, to a depth of 6 inches over the
bottom of the trenches. Finally, level the

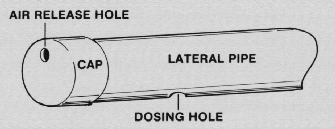

aggregate. Figure 10. Air release hole ensures that all wastewater drains from the lateral pipe after each dose.Remove all burrs around the dosing holes, both inside
and outside of the pipe, taking care not to enlarge
any hole beyond its design diameter. Be sure to
remove any loose chips from inside the lateral pipes
to prevent possible clogging of the dosing holes. If
the various parts of the network have been carefully
identified, the hole drilling and capping can be done
in a shop or workroom and then taken to the site for

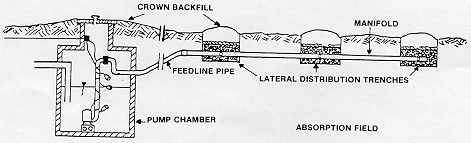

assembly. D. Backfilling the TrenchesStep 1: Carefully cover the pipe network
with additional washed Spec #5 gravel or approved
aggregate to a depth of at least 2 inches above the
crown of the pipe. Figure 11. Crown backfill over tanks and trenches.Step 4: Since settlement may take
6-12 months, the construction area should be resodded
or reseeded immediately using grasses adapted to the
area. E. Septic Tank and Pump Chamber InstallationStep 1: Excavation depths for the septic
tank and pump chamber are determined largely by what
is necessary to obtain gravity flow in the sewer from
the point where it leaves the house. A two percent
slope is required for the house sewer to the septic
tank while a one percent slope is sufficient for a
pipe carrying septic tank effluent. Make sure both
tanks are tightly sealed against groundwater seepage
before installation. The pump chamber should be the
same size or larger than the septic tank to allow for
at least one day of reserve storage of effluent after
the high water alarm is activated due to pump or float
failure. Figure 12. Cross sectional layout of pump chamber and associated components.Step 4: Plumb the pump to the
feedline with a riser pipe and quick-disconnect
coupler so the pump can be removed easily for
inspection and maintenance (Figure 12). The
quick-disconnect coupler should be located near the
access of the pump chamber to reduce the difficulty of
disconnecting the pump. Common couplers include
rubber or hose couplings anchored to the pipe ends by
hose clamps or plastic PVC unions. One coupling which
allows for quick disconnection or connection is the
cam-lock type connector used on fire hoses (Figure
13). Where practical, connectors should be made of
plastic instead of metal because the tank environment
is quite corrosive. If an effluent pump is used, a
1/4-inch weep hole should be drilled on the underside
of the feedline to allow drainage after each

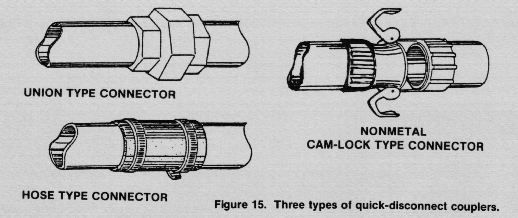

dose. Figure 13. Three types of quick-disconnect couplers.Step 5: Make the electrical
connections from the pump to the control circuitry.
The pump operation should be controlled by external
mercury float switches (allowing easy adjustment of
the dose volume) rather than a diaphragm controller
built into the pump body. Install a high-water alarm
float, approximately 3 inches above the high-water
control float, on an independently fused A.C. circuit
to alert the owner of a malfunction. All electrical
leads should be strapped to the riser pipe of the
pump, and should be long enough to allow the pump and
floats to be removed from the chamber without
electrical disconnection. Use nonmetallic, tamper and
weatherproof electrical boxes for all electrical
connections. The connection box may either be mounted
in the basement of the house or near the access to the
pump chamber. Be sure that the electrical circuitry
is grounded properly for the safe operation of
electrical equipment in a wet environment (according
to the National Electrical Code). F. Maintaining the SystemTraffic and construction must be avoided over and
immediately downslope from the soil disposal area to
prevent compaction and to minimize frost penetration.
You should maintain a good grass or vegetative cover
over the area to maximize the uptake of water. You
also should provide the homeowner with a layout
diagram of the septic system, referenced to the house
and lot boundaries. This will enable location of the
tanks and absorption field for future maintenance. Additional AssistanceIn addition to the FACTS computer program located at
each Indiana County Cooperative Extension office,
assistance in selecting and designing an on-site
system is available from your local county health
department and your local Soil Conservation Service
(SCS) office. In addition, some assistance may be
available for design of innovative systems from the
Purdue University On-Site Waste Disposal Project,
Agronomy Department, West Lafayette, IN 47907. NEW 1/85 (3M) Cooperative Extension Work in Agriculture and Home Economics, State of Indiana, Purdue University and U.S. Department of Agriculture cooperating. H.A. Wadsworth, Director, West Lafayette, IN. Issued in furtherance of the Acts of May 8 and June 30, 1914. It is the policy of the Cooperative Extension Service of Purdue University that all persons shall have equal opportunity and access to our programs and facilities without regard to race, color, sex, religion, national origin, age, or handicap. |
